S1 · Cement-treated gravel · Lead system

Light traffic in three days, trucks in seven, and no saw-cut joints

The 40 mm GridMats® grid (OC-HD 40 for trucks, OC-LW 40 for lighter traffic), laid on a compacted base and filled with crushed 6–12 mm chips treated with 4–6% cement, plate-compacted and brushed flush. Kerb or edge restraint on both sides; U-nails one per 2–3 m² on roads and slopes, one per 10 m² on flat yards, extra on embankments, edges and cut lines.

Get my free estimate   Download the flier (PDF) (opens in a new tab)   Installation at a glance (PDF) (opens in a new tab)

Illustrative render: cement-treated chips brushed flush with the cell tops of OC-HD 40

Installed cost, indicative*₹130–177 / sq ft(₹1,400–1,900 / m²)
Opens to traffic3 days · 7 dayslight vehicles · trucks, once the 7-day cubes reach 2 MPa
Laying rate300–400 m²of grid per crew-day
Product, for procurementOC-HD 40₹84–107/sq ft (₹900–1,150/m²) by order size, ex-works
3 daysto light traffic; trucks at 7, once the cubes pass
0saw-cut joints or dowels
170 t/m²lab compression test, empty OC-HD 40 panel (latest test report)
4.0–6.6 kg/m²recycled plastic reused (OC-LW to OC-HD)

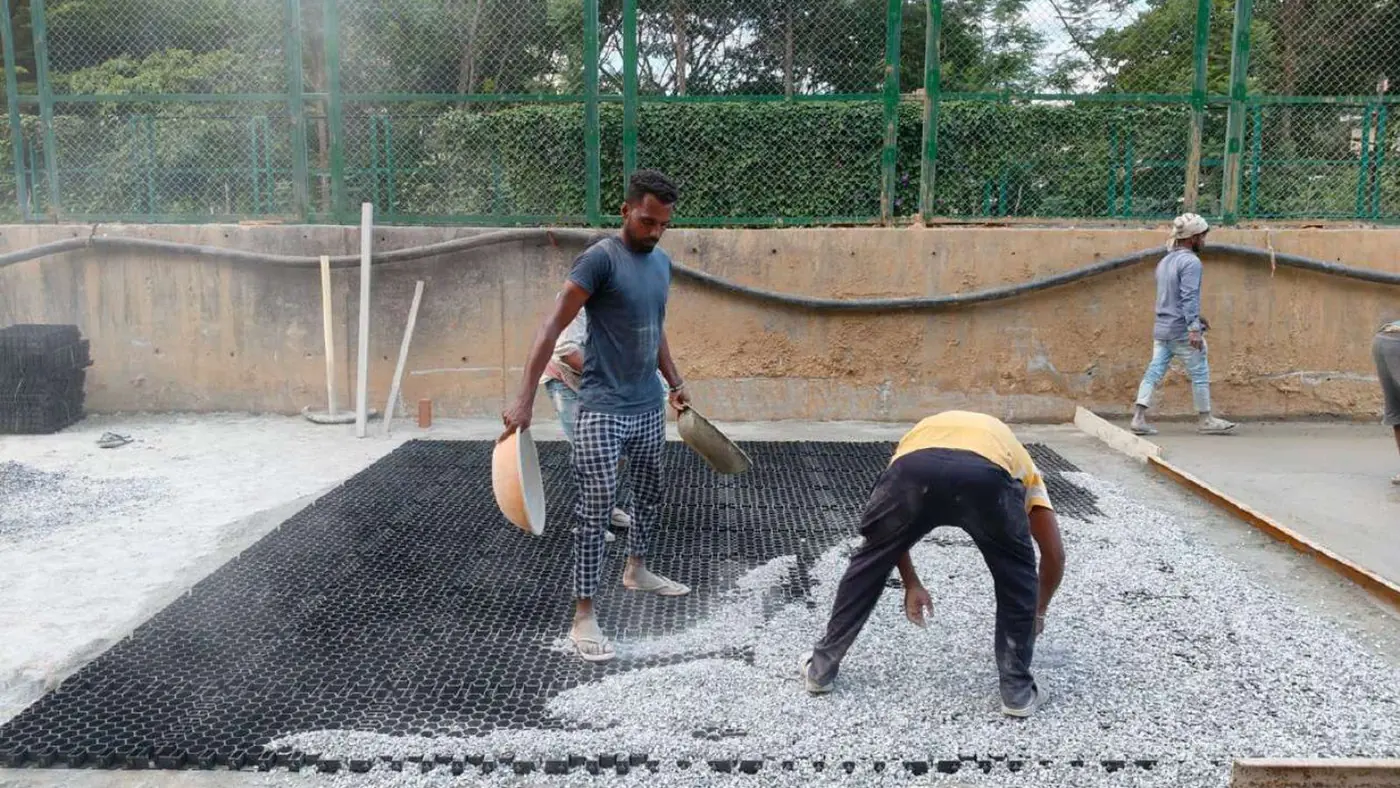

Grid, fill, finished

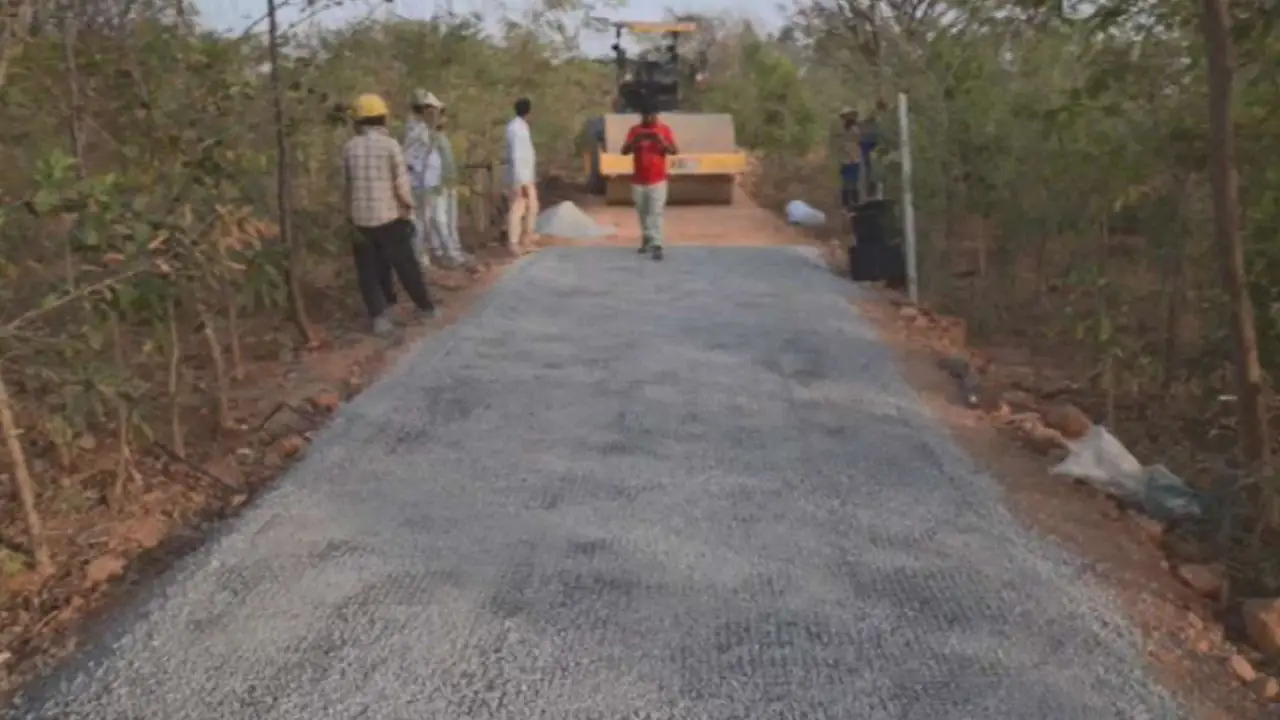

1Grid laid on the compacted base and filled with cement-treated chips

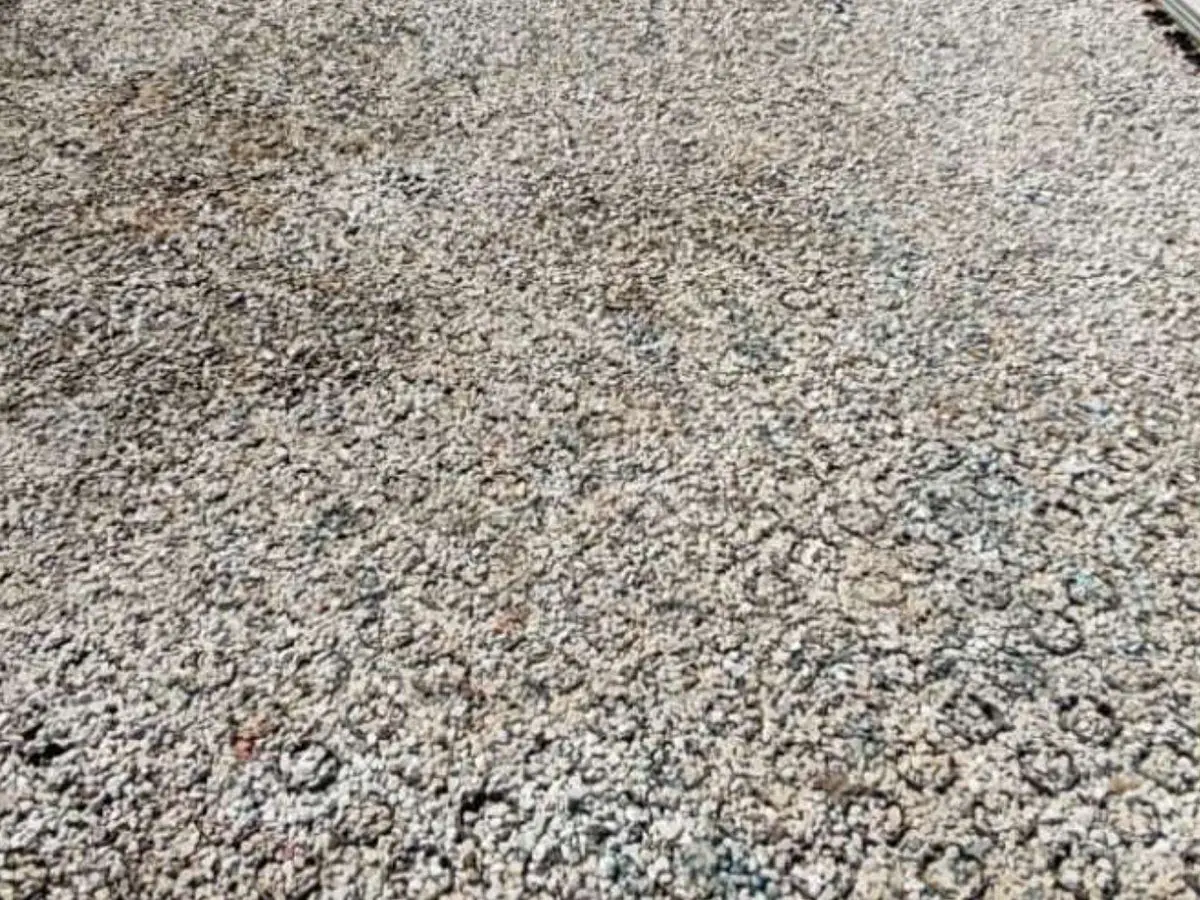

2Compacted and brushed flush with the cell tops

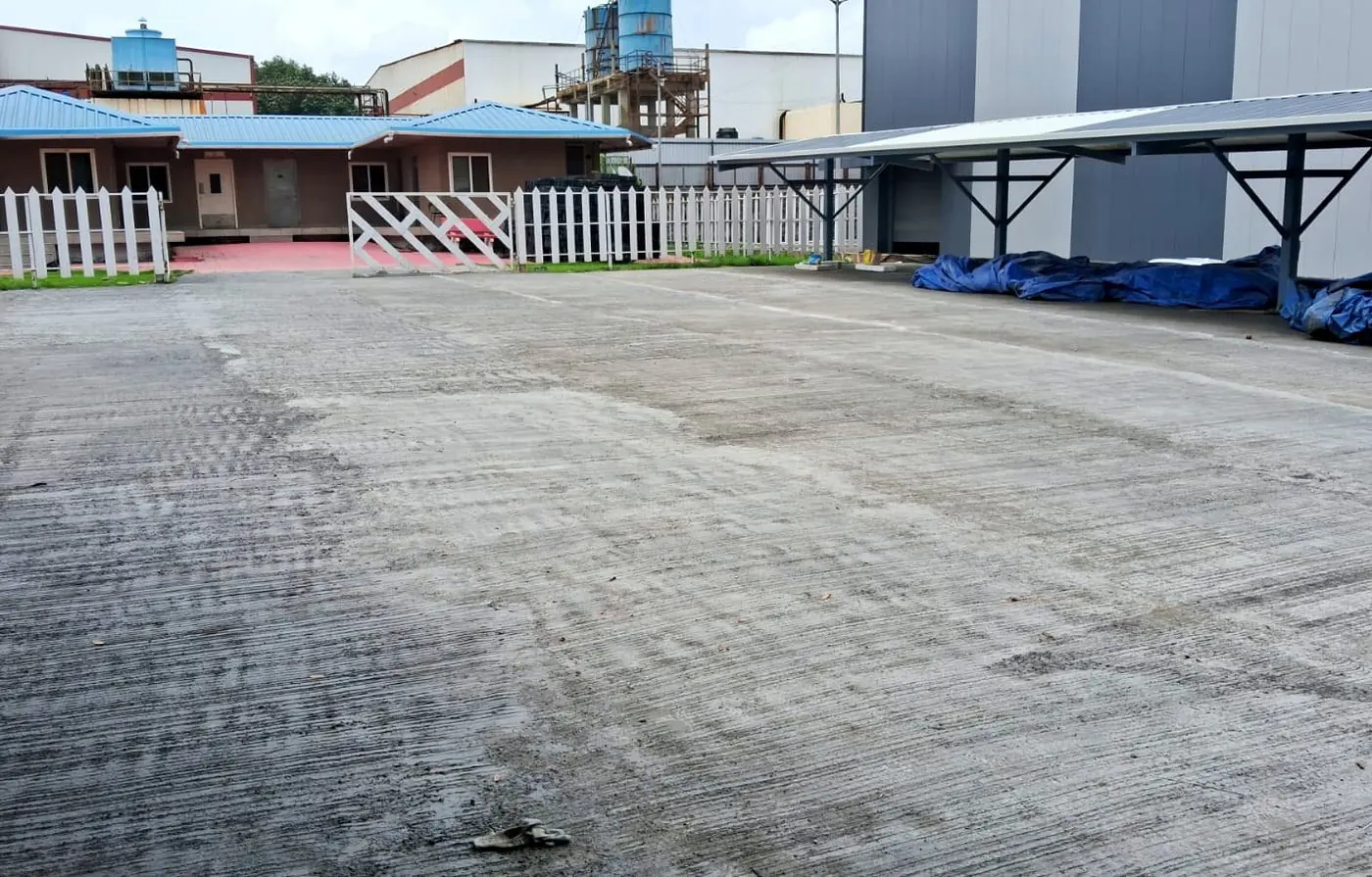

3Finished truck yard, moist-cured 3 days (RINAC, Mumbai, on OC-LW 40)

Why it wins

  • Built for trucks up to 49 t gross. The empty OC-HD 40 panel carried 170 t/m² in the latest lab compression test; the pavement itself is designed from your traffic and soil.
  • No saw-cut joints, no dowels. The cells arrest shrinkage cracks, so there is no joint cutting or sealing crew.
  • Light traffic in three days, not four weeks. Moist-cured 3 days; light vehicles at 3 days, trucks at 7 once the 7-day cubes reach 2 MPa. Built bay by bay in shutdown windows.
  • Dust-free, repairable. A hard grey surface that reads as concrete; damaged cells are refilled, not cut out.
  • Designed to the terrain and the rain. Cross-section by topography, drainage by rainfall intensity: plain or steep sites.
  • ESG line item. Per 1,000 m²: 6.6 t of plastic waste reused, and cement only in the 40 mm layer, at 4–6%. The handover file reports the numbers for your site.

Where it fits

Plant and factory roads · truck parking and marshalling yards · solar and wind park internal roads · fire lanes · container yards · township service roads.

Build-up

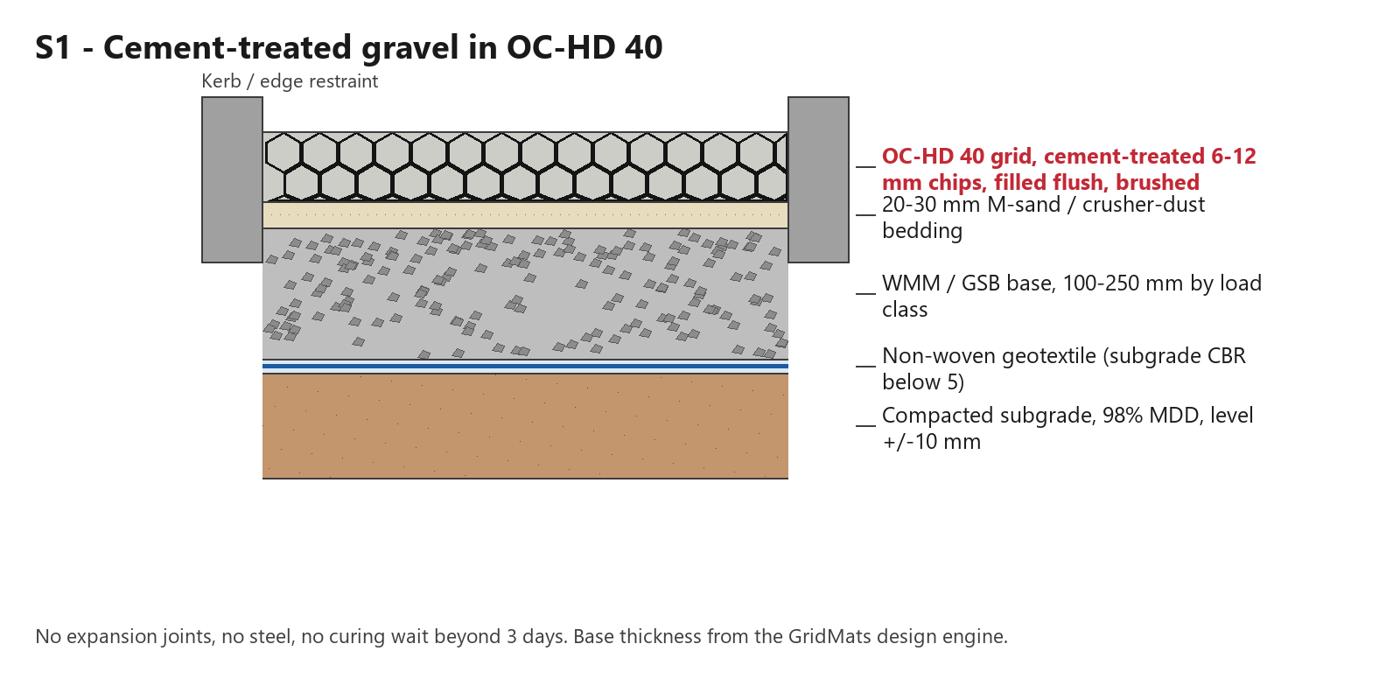

S1 cross-section

Choose S1 when

  • Trucks every day, up to 49 t gross (OC-HD 40; OC-LW 40 for lighter traffic)
  • A hard, dust-free grey surface
  • Light traffic in 3 days and trucks in 7
  • No saw-cut joints to cut, seal or crack

Not ideal when

  • The surface must be fully permeable: choose S2
  • The contract requires asphalt (S5) or a concrete finish (S4)

What we need from you

  • Area: length × width, or m²
  • Location: city or a map pin
  • Heaviest vehicle and vehicles a day
  • Soil CBR if you have it, or the soil type
  • The finish you want
  • A site photo or layout drawing

Get my free estimate

Datasheet

Installed rangeApplication timeTest dataProductProduct price, for procurementReference
₹130–177 / sq ft (₹1,400–1,900 / m²) indicative*300–400 m² of grid per crew-day · light traffic 3 days · trucks 7 days, once the 7-day cubes reach 2 MPa · supply date confirmed with the POLab compression tests on the panel: 170 t/m² empty (latest test report); filled, about 320 t/m² with cold asphalt and 3,200–4,000 t/m² with M25 concrete at 5 days (Stedrant, 2021) · mix designed for a 7-day UCS of 2–3 MPaOC-HD 40 for trucks (459 × 558 × 40 mm, 1.7 kg per panel) · OC-LW 40 for lighter traffic (500 × 500 × 40 mm) · 100% recycled PP₹84–107 / sq ft (₹900–1,150 / m²) OC-HD 40 by order size, ex-works · ex-GST · ex-freightRINAC, Mumbai: cold-storage truck yard on OC-LW 40 with 6% cement, 2025, in daily use

*Installed cost varies with local material availability, labour, transport, base design and site conditions; every site is priced from its own design. Product prices exclude GST (18%) and logistics.

On site

Installation at a glance

The six steps, what you need and when it opens, on one page. The installation guide comes by email on request; the SOP, the hold-point checklists and the method statement for your site come with your order. We train your contractor’s team: on site for up to 3 days for orders of 2,000 m² or more once the site is confirmed ready, online at no extra cost below that; on-site training is built into the product rate (one PO).

Download (PDF, 1 page) (opens in a new tab)

Test reports

Bureau Veritas and Stedrant load tests, GreenPro, patent 398992, IIT Hyderabad research. See Engineering.

Drainage and terrain

Designs are customised to geography, rainfall intensity and topography: sub-surface drains sized to the rainfall class, cross-sections for plain and steep terrain.

Watch

What would your road or yard cost on GridMats?

An indicative estimate in about a minute, free. Our engineers follow with the design and the bill of quantities against your conventional section; the method statement your contractor will follow comes with your order.

Get my free estimate   Talk to an engineer on WhatsApp (opens in a new tab)
